Tue, Feb 24

India’s BESS Tender Landscape (2025-2031): Policy Roadmap, Auction Trends & Viability Gap Funding Opportunities

Introduction: Why 2025–2031 Is the Decisive Phase for BESS in India

India’s power system is entering a structurally different phase. Renewable capacity additions are accelerating, peak demand is becoming sharper and less predictable, and grid operators are increasingly constrained by flexibility rather than generation capacity.

Between 2025 and 2031, Battery Energy Storage Systems (BESS) move from being “nice to have” assets to becoming essential grid infrastructure. This period matters because policy intent, tender design, and financing mechanisms are finally aligning with operational realities.

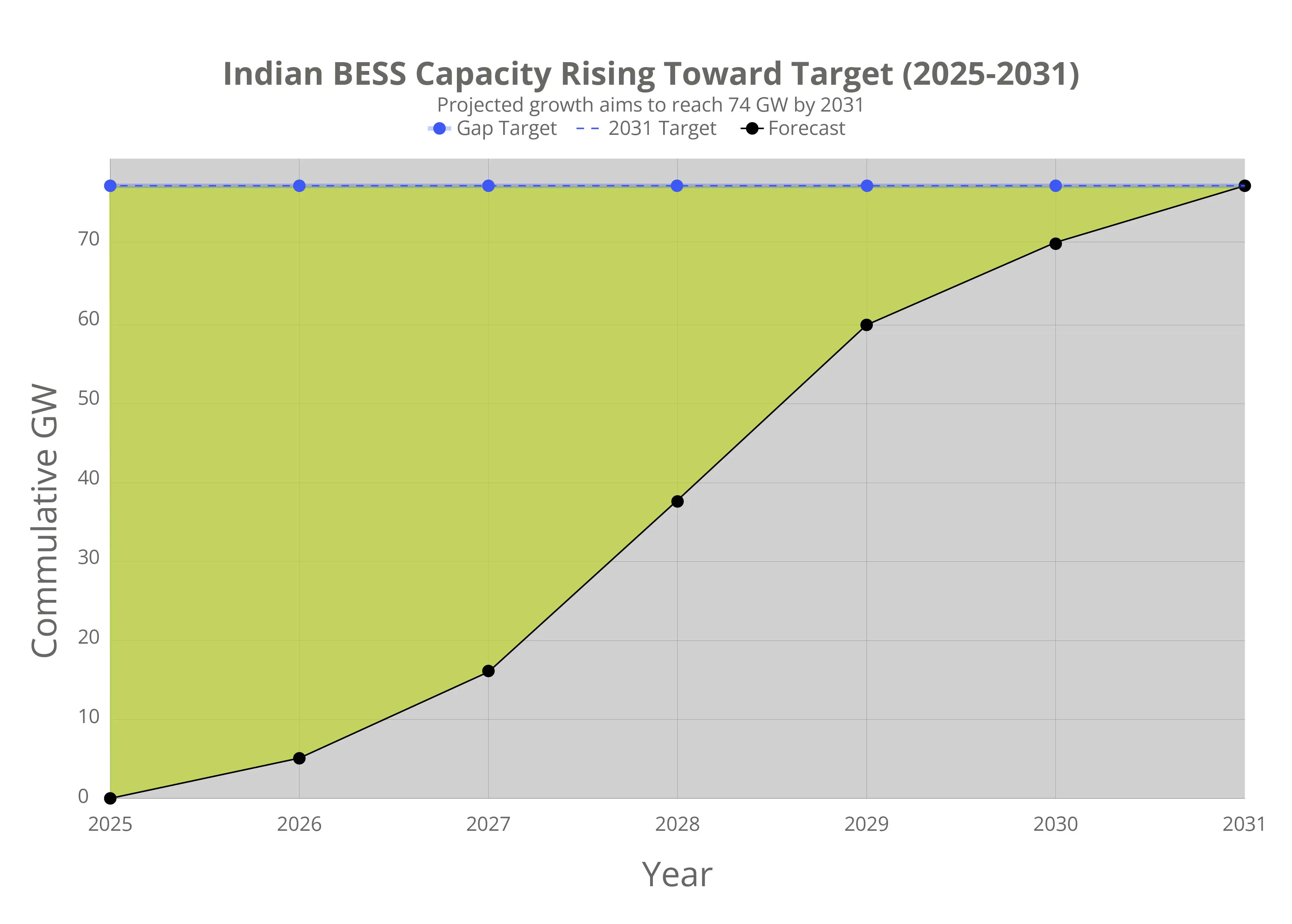

India has articulated a requirement of ~74 GW of energy storage by 2031–32, while current installed BESS capacity remains around 205 MW (Source). The gap is not incremental, it is exponential. How tenders are structured, how risks are allocated, and how projects are financed during this window will determine whether storage scales smoothly or stalls at pilot level.

India’s BESS Policy Roadmap

National targets and system drivers

India’s storage roadmap is being shaped by three system-level drivers:

  1. High solar penetration causing midday surplus and evening deficits

  2. Peak demand growth driven by cooling, EV charging, and urbanisation

  3. Grid stability requirements as coal flexibility reaches its limits

The National Electricity Plan (NEP) and subsequent ministry briefings have made it clear that storage of both pumped hydro and BESS will be required at scale to balance the grid by the early 2030s.

Unlike earlier renewable programs, storage is not being positioned purely as a generation asset. It is increasingly treated as capacity, flexibility, and reliability infrastructure.

Institutional roles shaping tenders

  • MNRE sets the overall policy direction and enables fiscal support mechanisms

  • CERC defines how storage participates in markets and ancillary services

  • SECI and NTPC act as central procurement agencies, issuing large, standardised tenders

  • State DISCOMs ultimately determine demand through PPAs and state-level RFPs

What has changed since 2023 is that these institutions are no longer operating in silos. Tender documents now reflect coordination between policy intent, grid needs, and financing constraints.

Evolution of BESS Tender Models in India

Standalone BESS tenders

Standalone BESS tenders procure storage capacity independently of renewable generation. These tenders typically compensate projects through a combination of:

  • Availability or capacity payments

  • Energy discharge payments

  • Performance-linked incentives

SECI’s recent standalone BESS tenders signal a shift toward treating storage as dispatchable infrastructure rather than as an appendage to renewables.

Renewable + storage tenders

Hybrid tenders combine solar or wind with co-located storage. Their objective is straightforward: smooth output, firm supply during peak hours, and reduce reliance on grid balancing.

These tenders are particularly attractive where transmission incentives or scheduling benefits apply, but they also introduce complexity in dispatch optimization and degradation management.

Ancillary services and capacity-based procurement

CERC’s ancillary services framework now allows storage to participate in frequency regulation and reserves. While still evolving, these markets are critical for revenue stacking, which is essential for long-term project viability.

Auction Design & Pricing Trends

Capacity versus energy payments

One of the most important design choices in BESS tenders is the balance between:

  • Capacity-style payments, which stabilise cash flows

  • Energy-linked payments, which expose projects to dispatch and tariff risk

Early tenders leaned heavily on energy payments. Recent tenders increasingly include capacity-linked components to improve bankability.

Contract tenors and risk allocation

Tenors are lengthening toward 10–15 years, but with tighter clauses on:

  • Degradation assumptions

  • Availability guarantees

  • Penalties for under performance

This reflects a more mature understanding of battery behaviour over lifecycle operation.

Benchmark pricing (contextual, not absolute)

Tariffs and capacity charges vary widely by state, grid condition, and tender design. What matters more than headline numbers is risk-adjusted pricing how much volatility a project can absorb without eroding equity returns.

Viability Gap Funding (VGF): Why It Matters for BESS

What is VGF in the context of BESS?

Viability Gap Funding is fiscal support provided to bridge the gap between market-acceptable tariffs and the actual cost of delivering a project at bankable returns.

For BESS, VGF is not a subsidy for inefficiency. It is a transition tool that recognises that early storage deployments deliver system-wide benefits not fully monetised by current markets.

How VGF improves bankability

Properly structured VGF:

  • Lowers upfront capital burden

  • Improves debt service coverage ratios

  • Reduces tariff pressure on DISCOMs

  • Encourages standardisation and scale

Recent SECI tenders have demonstrated how capped VGF, linked to commissioning milestones, can accelerate deployment without distorting incentives.

Project Bank ability & Developer Economics

Revenue stacking is no longer optional

A bankable BESS project in India today must combine multiple revenue streams:

  • Peak-hour energy arbitrage

  • Capacity or availability payments

  • Ancillary services participation

  • Demand response or grid support services

Single-revenue models are fragile in India’s evolving power market.

Key risks developers must model realistically

  • Tariff volatility, especially during peak hours

  • Battery degradation, which reduces usable capacity over time

  • Dispatch uncertainty, particularly in nascent ancillary markets

Projects that fail typically do so because these risks were underestimated, not because technology failed.

Why multi-cycle dispatch improves economics

Multi-cycle operation charging from solar during the day and discharging across multiple peak windows materially improves asset utilisation.

However, this only works when:

  • PCS efficiency is high

  • Thermal management is robust

  • EMS logic is optimised for real grid conditions

Several Indian solution providers, including GoodEnough Energy, have been deploying BESS systems like StorEDGE with a focus on multi-cycle operation, thermal efficiency, and dispatch optimisation. These deployments are valuable not because of branding, but because they generate operational data that financiers and tendering agencies increasingly demand.

Outlook: 2025–2031

Expected scale-up trajectory

India’s BESS market is expected to move from hundreds of megawatts to multiple gigawatts annually by the late 2020s. Centralised tenders will dominate early volumes, followed by greater state-level and private procurement. (Source)

Policy gaps still to be addressed

  • Long-term clarity on transmission charges post-waiver period

  • Standardisation of degradation and availability clauses

  • Faster grid interconnection approvals

What developers and investors should prepare for

  • Conservative, scenario-based financial models

  • Strong EMS and system integration capabilities

  • Clear warranty, O&M, and performance recourse

  • Evidence from pilot or operating assets

    Conclusion

India’s BESS tender landscape between 2025 and 2031 will define the country’s ability to integrate renewables reliably and affordably. The opportunity is large, but so are the execution risks.

Projects that succeed will not be those that bid the lowest tariffs, but those that combine sound policy understanding, realistic economics, and operational discipline. Storage in India is no longer about experimentation it is about building infrastructure that works, scales, and lasts.
